Solar installers

Installing the right hardware and configuring it correctly allows customers to get most from their solar systems. This page explains the connection process, lists hardware approved to connect to our network, and shows how to make installations comply with the Victorian Government’s emergency backstop requirements.

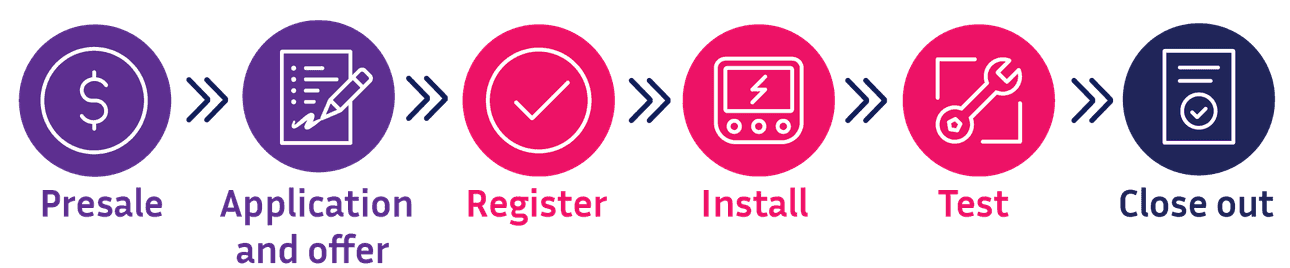

Steps to connection

All new, upgrading and replacement rooftop solar systems, at or below 200kVA, must be emergency backstop enabled. To be emergency backstop enabled, a solar system must be able to communicate using the Common Smart Inverter Profile Australia (CSIP-AUS) technology protocol and be connected to the internet.

Before you go

Presale

Application and offer

  • Check with the manufacturer to make sure you have the required hardware for the installation, including an export limiting meter
  • Submit a pre-approval application via myEnergy and advise the customer of outcome

While on site

Install

  • Install an approved CSIP-AUS solar inverter and export limiting meter as per the manufacturer’s installation guide
  • Configure the inverter and associated equipment to the customer’s internet
  • Ensure the device has the latest firmware and inverter is set to Region A settings AS4777.2.2020

Register

  • Register the customer's solar inverter via the manufacturer's app
  • Create and verify a Long Form Device Identifier (LFDI) for the inverter
  • Confirm successful registration with United Energy

Test and close out

Test

  • Initiate the capability test (takes about 10 minutes)
  • Confirm capability test is successful


Close out

  • Arrange for a Licensed Electrical Inspector (LEI) to inspect and approve the installation
  • Submit the alteration in myEnergy and attach the Certificate of Electrical Safety (CoES)

Support and assistance

Our New Energy Services team are the first point of contact for solar installers.

Contact them at newenergyservices@ue.com.au or on 1800 772 940 (8am-4pm, Monday to Friday).
